Overview

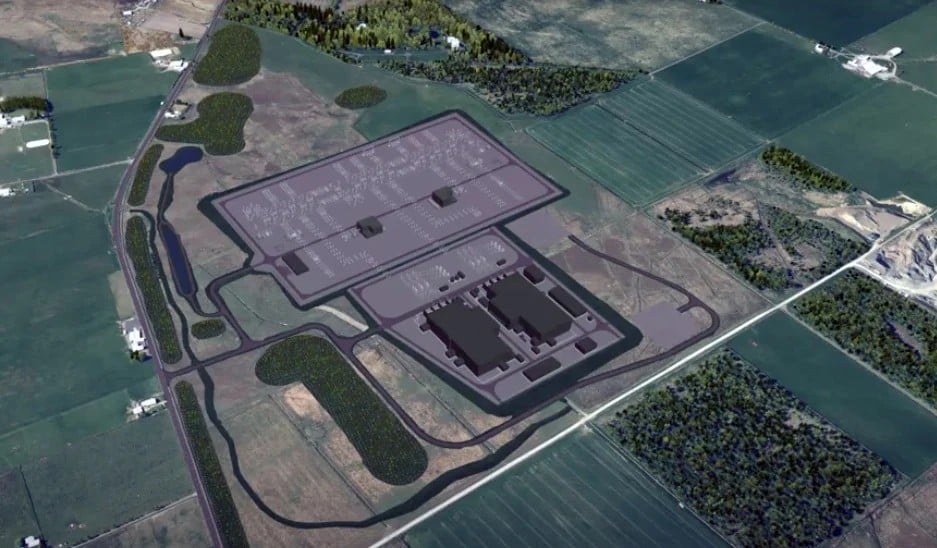

Planning consent granted for the Banniskirk Hub - delivering major boost to clean energy ambitions
Planning consent has been granted for the Banniskirk Hub, a major clean energy project that will see the construction of a new 400kV substation and high voltage direct current (HVDC) converter station in the Spittal area.
The decision made by The Highland Council’s North Planning Applications Committee on 26 November 2025, follows more than two years of development and extensive community and stakeholder engagement by SSEN Transmission.
The Banniskirk Hub will connect to the proposed 400kV overhead line between Spittal and Beauly, as well as the existing Spittal 275kV Substation. It will feature a new outdoor 400kV Air Insulated Switchgear (AIS) substation, and an HVDC converter station enabling the transfer of offshore renewable energy to demand centres across the country via the Spittal–Peterhead subsea cable link.
Consent for Banniskirk follows the recent approval of the marine licence for the Spittal - Peterhead project, meaning all permissions are now in place for the subsea link to begin.
3D Visualisations Portal
To help provide an indication of what the substation and HVDC converter station may look like within the local environment, we've created a 3D visualisation portal. The portal can be accessed via the following link, where you can view various viewpoints from around the proximity of the site as well as a flythrough video.
Visit the 3D visualisations portal

About the Project
In order to support the continued growth in onshore and offshore renewables across the north of Scotland, supporting the country's drive towards Net Zero, investment in network infrastructure is needed to connect this renewable power and transport it from source to areas of demand across the country.
Extensive studies have confirmed the need to reinforce the onshore transmission infrastructure between Spittal and Beauly, and the need for a subsea cable between Spittal and Peterhead. To enable these reinforcements, a new 400kV substation is required in Spittal and will connect to:
- A new 400kV connection between Spittal and Beauly
- A new Spittal HVDC Converter Station
- The existing Spittal 275kV Substation
Find Out More About Spittal - Loch Buidhe - Beauly 400kV Connection
This video outlines how the project contributes to our role in delivering Net Zero.
Pathway to 2030
We are investing over £29bn to upgrade the network infrastructure across the north of Scotland between now and 2030. As a mass transporter of renewable energy, the north of Scotland electricity transmission network has a major role to play in supporting the delivery of Scotland and the UK’s 2030 net zero targets.
This investment is critical to powering change, improving energy security using home-grown low carbon electricity, and supporting significant economic and employment opportunities across the UK, 17,500 of which will be in Scotland and 8,400 of these in the north of Scotland. Other benefits the projects will bring include over £100m of Community Benefit Funds, contributing to the development of 1000 properties in the north of Scotland and delivering 10% net gain in biodiversity.
The projects include new overhead lines, substations and subsea links and are part of a major upgrade of the electricity transmission network across Great Britain.
Stakeholder Engagement
The New Spittal 400kV Substation Project is currently in the development stages and is subject to extensive consultation with stakeholders. In this video, Rebecca Gay, Project Manager for the overhead line project, and Community Liaison Manager, Martin Godwin, describe the approach we are taking in developing our proposals and the opportunities that are available for stakeholders to feed into the design process.
How we’re embracing artificial intelligence (AI)
We intend to use AI to assist our experienced teams in the analysis of your feedback, so we can categorise key points raised more quickly. You can learn more about how we’re utilising AI on this dedicated web page.
Project Updates
Featured updates
Featured updates for this project
Upcoming preparatory works at Banniskirk Hub
We're here to lend a helping hand
Project updates
Documents
Community Liaison Group meetings
Environmental Impact Assessment Report
Pre-Application Consultation - March 2024
-
Banniskirk Hub - Pre Application Consultation - Feedback Booklet June 2024.pdf
- Type:
- Date:
- 27 May 2024
- Size:
- 4.8 MB
This document provides information to our stakeholders about the project and was provided during our consultation in June 2024
-
Banniskirk Hub - Indicative site layout plan (1).pdf
- Type:
- Date:
- 27 May 2024
- Size:
- 8.3 MB
This map provides information to our stakeholders about the site layout of the Banniskirk 400kV substation, produced 15 May 2024
-
Banniskirk Hub - Indicative site layout plan (2).pdf
- Type:
- Date:
- 27 May 2024
- Size:
- 1.9 MB
This map provides information to our stakeholders about the site layout of the Banniskirk 400kV substation, produced 15 May 2024
-
Banniskirk Hub - Pre Application Consultation - Mailer.pdf
- Type:
- Date:
- 27 May 2024
- Size:
- 597.4 KB
This document provides information to our stakeholders about our consultation events in June 2024
-
Banniskirk Hub mailer.pdf
- Type:
- Date:
- 26 February 2024
- Size:
- 652.1 KB
This document provides information to our stakeholders about our consultation events in March 2024
-
Banniskirk Hub PAC booklet - March 2024.pdf
- Type:
- Date:
- 26 February 2024
- Size:
- 8.4 MB
This document provides information to our stakeholders about the project and was provided during our consultation in March 2024
-
Banniskirk Hub PAN boundary.pdf
- Type:
- Date:
- 26 February 2024
- Size:
- 2.4 MB
This map provides information to our stakeholders about the Proposal of Application Notice (PAN) red line boundary for the site.
Report on Consultation
-
Summary ROC - Spittal to Beauly
- Type:
- Date:
- 01 December 2023
- Size:
- 4.8 MB
This Report on Consultation (and associated appendices/maps) documents the consultation process which has been undertaken for the project at corridor, routeing, alignment or substation site selection stage. It describes the key responses received and provides detail on the actions proposed in response to the issues raised.
-
Report on Consultation - New Spittal Area 400kV Substation and HVDC Converter Station
- Type:
- Date:
- 01 December 2023
- Size:
- 1.5 MB
This Report on Consultation (and associated appendices/maps) documents the consultation process which has been undertaken for the project at corridor, routeing, alignment or substation site selection stage. It describes the key responses received and provides detail on the actions proposed in response to the issues raised.
-
RoC - New Spittal Area 400kV Substation - Figure 2 - Spittal Proposed Substation and HVDC Converter Station Site
- Type:
- Date:
- 01 December 2023
- Size:
- 4.1 MB
This Site Selection Consultation Document (and associated appendices/maps) explains the project need and summarises the process which has been followed to arrive at the optimal site. It forms part of the consultation exercise which provides all interested parties with the opportunity to provide feedback.
-
RoC - New Spittal Area 400kV Substation - Figure 1 - Site Selection Options
- Type:
- Date:
- 01 December 2023
- Size:
- 6.7 MB
This Site Selection Consultation Document (and associated appendices/maps) explains the project need and summarises the process which has been followed to arrive at the optimal site. It forms part of the consultation exercise which provides all interested parties with the opportunity to provide feedback.
Additional Information
-
Report on Consultation - Community Council Briefing Slides - SLBB
- Type:
- Date:
- 13 December 2023
- Size:
- 3 MB
This Report on Consultation (and associated appendices/maps) documents the consultation process which has been undertaken for the project at corridor, routeing, alignment or substation site selection stage. It describes the key responses received and provides detail on the actions proposed in response to the issues raised.
-
Spittal 400kV Substation Hub_Site Selection_Consultation Document Aug 2023
- Type:
- Date:
- 05 October 2023
- Size:
- 10.1 MB
This Site Selection Consultation Document (and associated appendices/maps) explains the project need and summarises the process which has been followed to arrive at the optimal site. It forms part of the consultation exercise which provides all interested parties with the opportunity to provide feedback.
-
Consultation Report - Spittal - Loch Buidhe - Beauly - July 23
- Type:
- Date:
- 13 July 2023
- Size:
- 1.3 MB
This Report on Consultation (and associated appendices/maps) documents the consultation process which has been undertaken for the project at corridor, routeing, alignment or substation site selection stage. It describes the key responses received and provides detail on the actions proposed in response to the issues raised.
-
Consultation response May 2023
- Type:
- Date:
- 17 May 2023
- Size:
- 166.2 KB
This is our initial response to the consultation feedback received for the project.
-
pittal-Loch Buidhe-Beauly initial consultation feedback response 28.03.23.
- Type:
- Date:
- 28 March 2023
- Size:
- 199.9 KB
This is our initial response to the consultation feedback received for the project.
-
Spittal Consultation Substation Options Map Feb-March 23
- Type:
- Date:
- 27 February 2023
- Size:
- 6.7 MB
This map provides information to our stakeholders about the route options.
-
Consultation Booklet (Spittal - Loch Buidhe - Beauly 400kV)
- Type:
- Date:
- 17 February 2023
- Size:
- 67.3 MB
This material provides information to our stakeholders about the project and/or consultation events.
-
Public Consultation Poster - Feb/March 2023
- Type:
- Date:
- 06 February 2023
- Size:
- 101 KB
This material provides information to our stakeholders about the project and/or consultation events.
Our Contractor
Introducing Our Principal Contractor: Murphy
We are pleased to announce that Murphy has been appointed as the principal contractor for the Banniskirk Hub Project. Murphy is a leading engineering and construction company with a strong reputation for delivering complex infrastructure projects across the UK and internationally. Their expertise spans sectors including energy, natural resources, power and transportation, ensuring the highest standards of safety, quality, and sustainability.
As part of the Banniskirk Hub project, Murphy will oversee the construction of the new substation, working closely with SSEN Transmission to support the delivery of critical network upgrades that will enable a low-carbon future.
For more information about Murphy and their services, please visit www.murphygroup.com.
Alongside our own SSEN Transmission Community Liaison Manager, for construction specific queries on the project, Murphy can be contacted directly at: ASTIcomms@murphygroup.com
In addition to the Banniskirk Hub, Murphy have been appointed the principal contractor for the Carnaig 400kV substation and the proposed 400kV overhead line connecting Banniskirk Hub and Carnaig substation. To find out more about Murphy's role in delivering on our Pathway to 2030 programme, visit their dedicated project page: https://www.murphygroup.com/project/asti/
Murphy has also recently opened new offices in Thurso and Alness, as highlighted in the video below.

FAQs
Who we are
About the Pathway to 2030 projects
Our approach to routeing and public consultation
Environmental considerations
Community and landowner considerations
Cost and engineering considerations
